New Vessels Update | August Newsletter

Introduction

This newsletter brings you the latest on vessel progress, key milestones, and recent visits to Vietnam, as well as a first look at design concepts for the interiors. With momentum building and launch preparations now on the horizon, we are moving ever closer to delivering a modern, sustainable fleet for the islands.

Business of the year

We were proud to be named Business of the Year at the 2025 Maritime UK Awards in June.


This recognition came as we marked one year since the first steel was cut for our new vessels, Scillonian IV and Menawethan – a major milestone representing the biggest investment in the Isles of Scilly’s transport in a generation.

The award celebrated our commitment to innovation, advanced technology, and excellence in building these state-of-the-art vessels. It was a proud moment for everyone involved at the Steamship Group and reinforced our dedication to delivering a sustainable, modern fleet that will serve the community for decades to come.

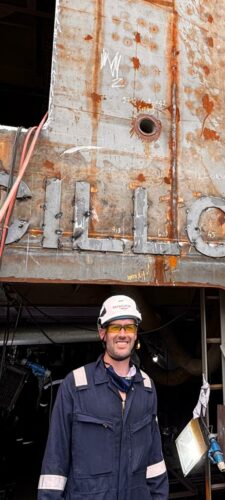

Luke Parnell | Visit to Vietnam shipyard


In May we welcomed Luke Parnell as our new Technical Superintendent, playing a pivotal role in overseeing and managing the maintenance of our vessels.

Chief Executive Stuart Reid said:

“Luke’s familiarity with our current vessels and operations, as well as experience with new builds, will be a real asset for the future.”

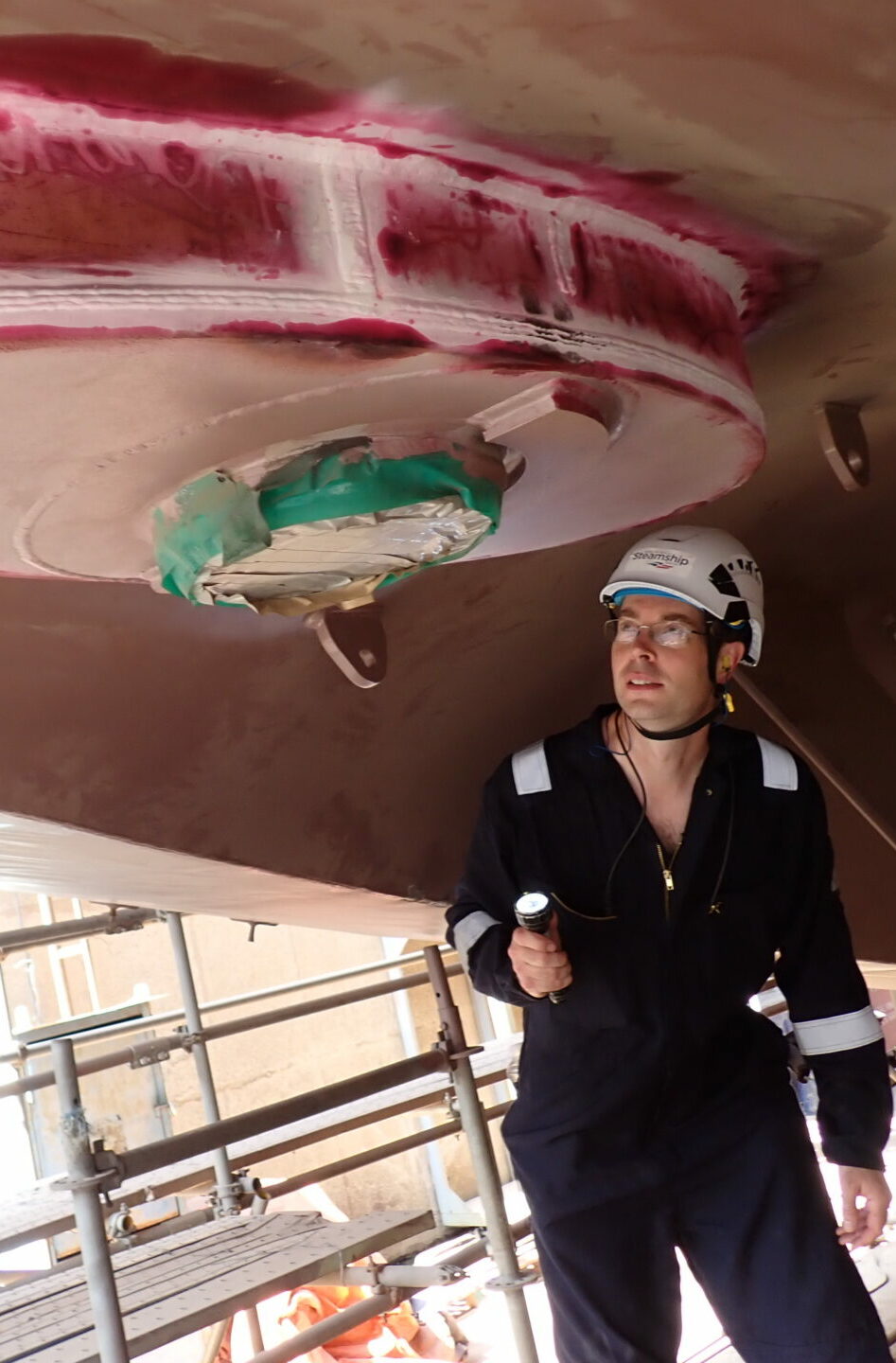

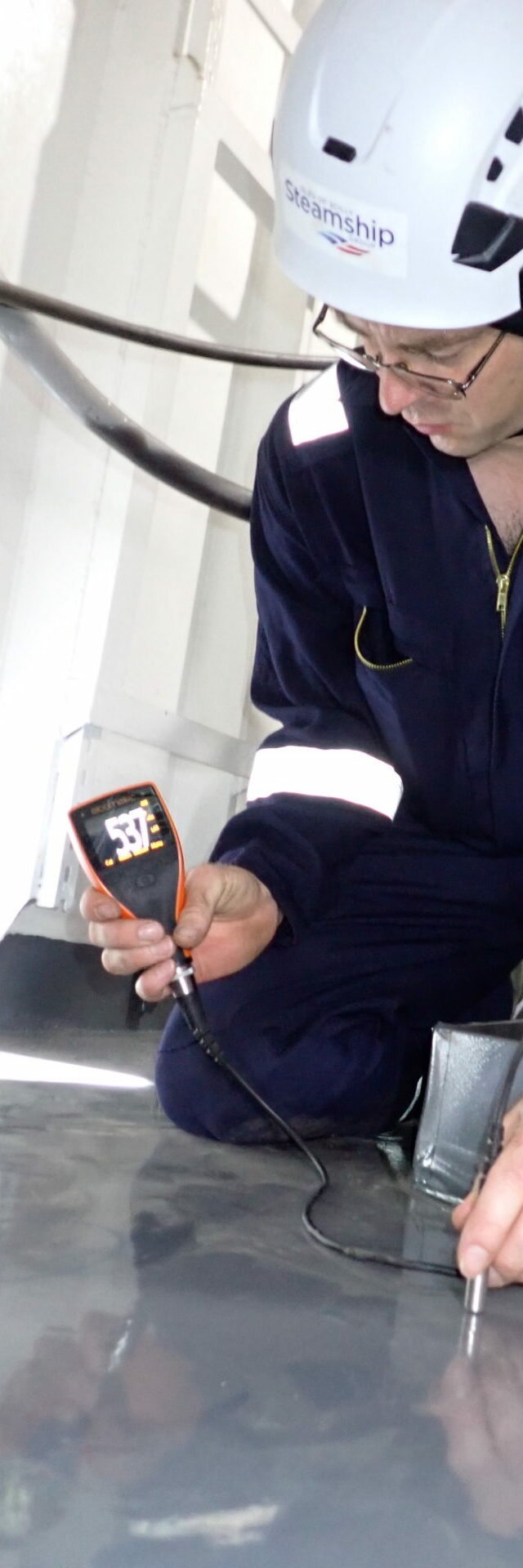

Earlier this month, Luke visited Piriou’s shipyard in Vietnam to familiarise himself with Scillonian IV and Menawethan. He will return at the end of August for a two-week period, providing cover for Chris and Peter during their annual leave.

During this visit, Luke will oversee key stages of progress. On Scillonian IV, he expects to see the completion of welding installation and integrity testing of the starboard fin stabiliser, as well as the final inspection of Void 1 before it is sealed for the next five years. He will also check on the installation of the floating floor on Deck 2, which is on course to be completed during his time in the yard. The main gearbox preliminary alignment should also be finalised, with full alignment scheduled once the vessel is afloat.

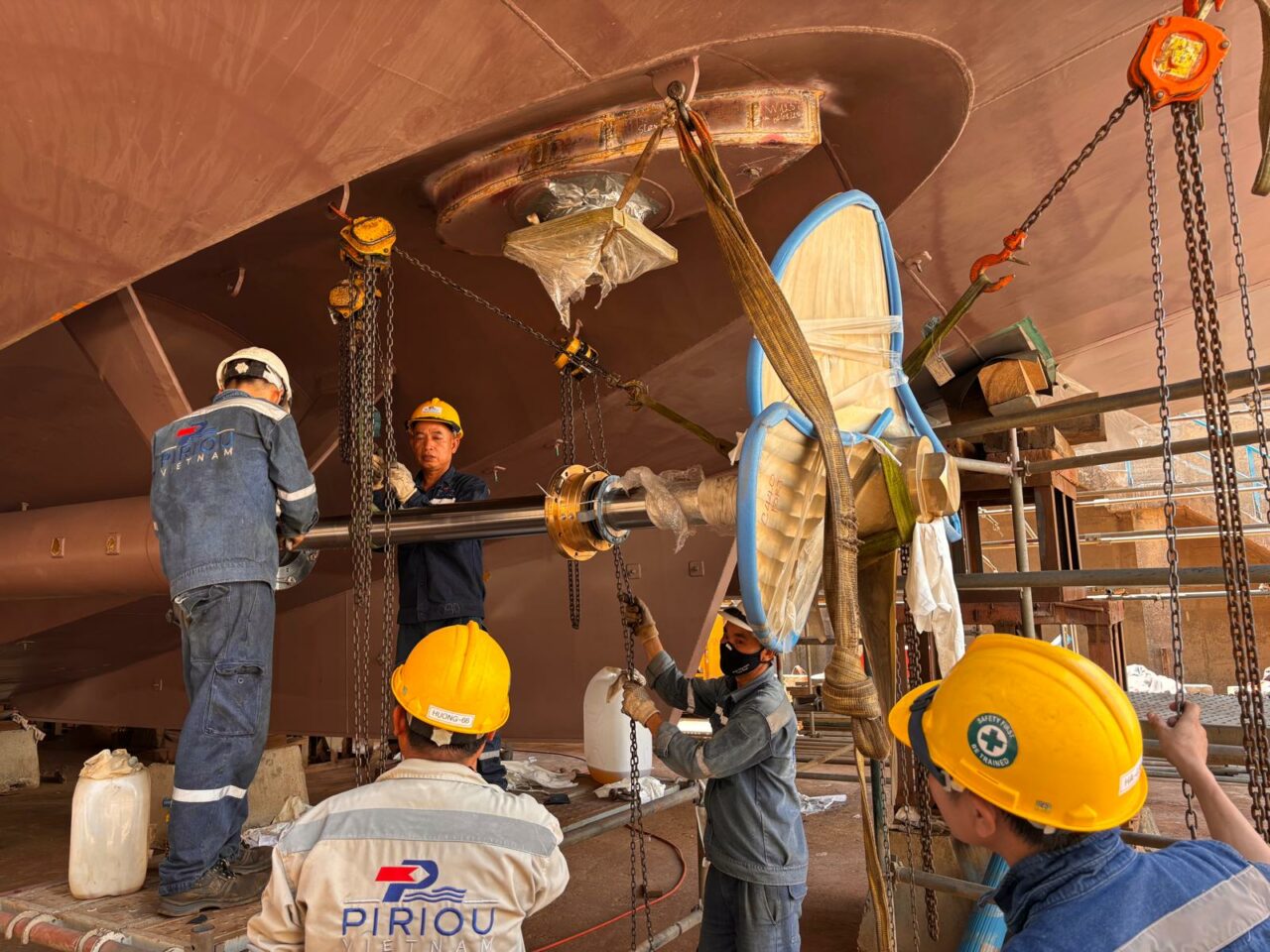

On Menawethan, Luke will attend the final inspection of the propellers and tailshafts, while advanced systems testing continues. Both the compressed air system and the sewage vacuum system are due to be presented for inspection by Owners and Class. Inspections of the anchor chain locker and pallet lift are also planned. Externally, the final topcoat of hull paintwork should be completed during his stay.

Stuart Reid | Visit to Vietnam shipyard


“Seeing the vessels in Vietnam come to life since we started this project in 2019 is inspiring and a proud moment for the Company.”

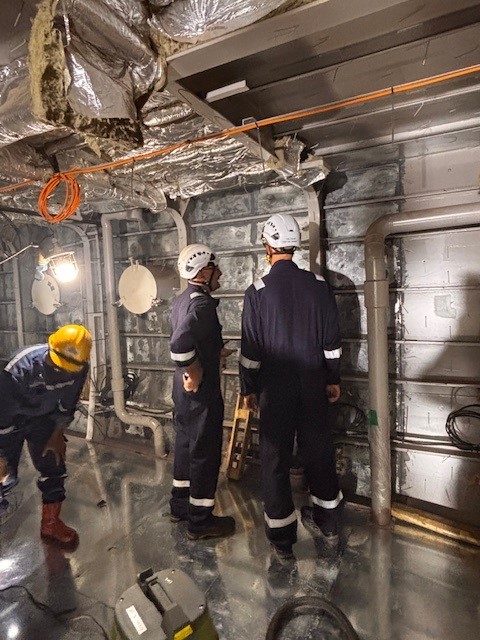

Earlier this month, Stuart Reid travelled to Vietnam for an important stage in the vessel build. His visit included time at the Piriou shipyard to inspect progress on both vessels, as well as a stop at the furniture manufacturing factory to review materials and the quality of construction for the passenger lounges furniture and interior outfitting.

It was also a valuable opportunity to spend time with project managers Chris and Peter, who have been based in Vietnam for the past 14 months. Seeing first-hand the strong relationships they’ve built with the workforce was a highlight, and we’re proud of the professionalism and commitment they continue to bring to the project.

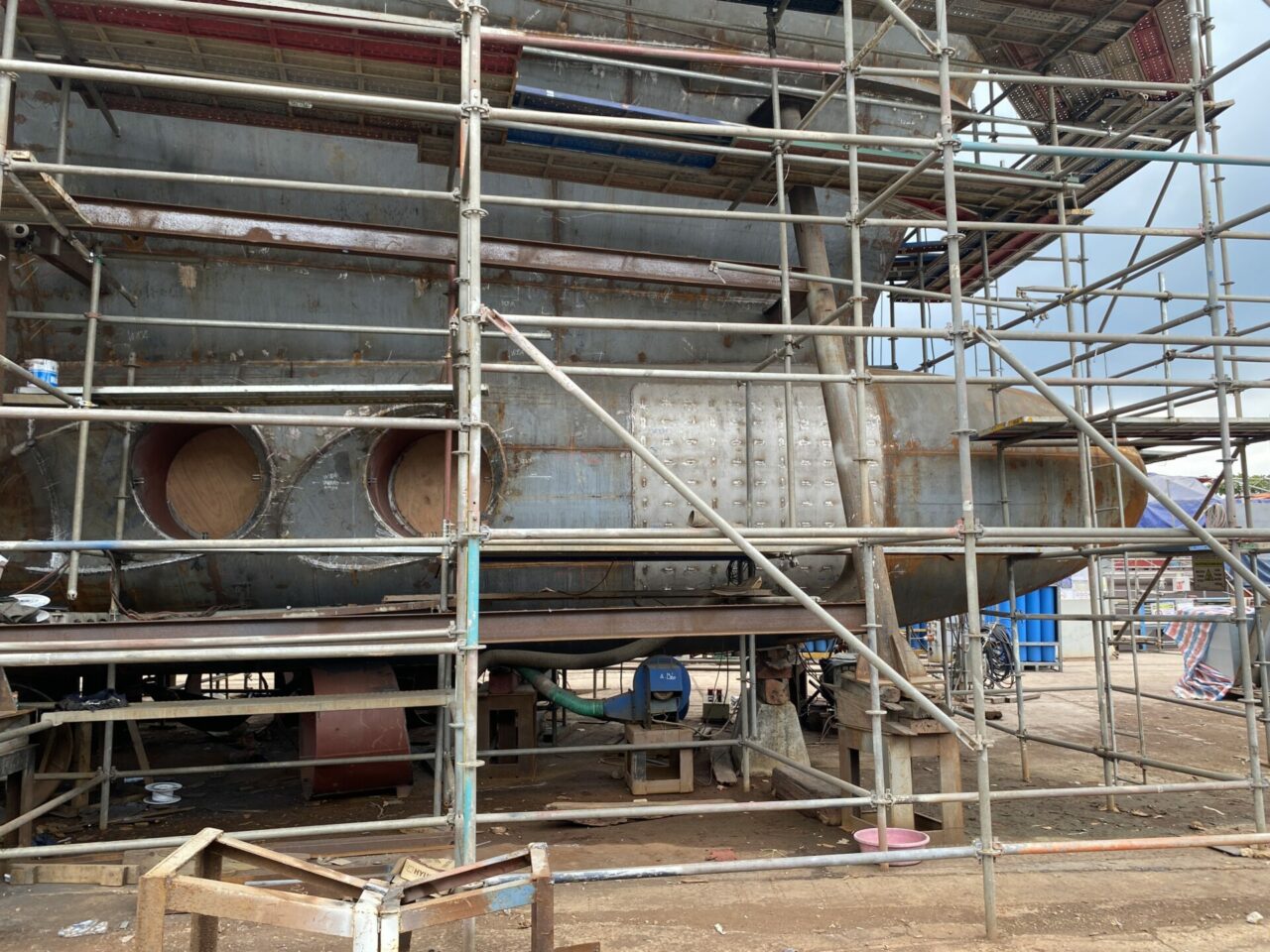

Since Stuart’s last visit, the transformation has been remarkable: hull units fully integrated, staircases and engines in place, windows being installed, and electrical teams laying kilometres of cabling each week.


Scillonian IV interior concepts

In this issue, we’re pleased to share a conceptual look into Scillonian IV, created by design specialists. These concepts help visualise the overall look and feel of the vessel’s interior as we reach a key stage in development, moving from initial ideas towards final designs, materials, and finishes. They illustrate the vision for passenger lounges, café areas, and other key spaces on board.

During his visit to the furniture manufacturing factory in Ho Chi Minh, Stuart Reid reviewed interior materials being prepared for fit-out and provided feedback on elements that were well received by the shipyard. The factory, renowned for superyacht outfitting, showcased the high-quality construction and materials being deployed for the vessel.

The discussions and feedback from this visit will guide the next stage of development, helping ensure the interiors achieve the right balance of comfort, style, and functionality for passengers.


Our next key milestones

Things have progressed at pace over in Vietnam since our last newsletter in June with exciting and key milestones coming up over the next few months.

Menawethan launch

The next major milestone will be the Menawethan’s launch from the dock, which will happen in October. The launch will not be a traditional launch. Instead on the day of the launch the dock will slowly fill with water and once afloat, Menawethan will exit the dock. This precision undocking process is to prevent disturbance to Scillonian IV which is being constructed in the same dock. Once Menawethan has exited the dock she will come alongside one of the berths in the shipyard and start her commissioning followed by sea trials at the end of the year.

Further shipyard visits

As the vessels move closer to their commissioning and trial phases members of our management team and crew will start making visits to our new vessels.

Our Marine Superintendent Tom Weise and Scillonian III Master Dave Redgrave will be visiting the shipyard this Autumn.

The purpose of their visit will be to undertake planning for crew familiarisation training later in the year.


Recent news bites

In case you missed it, here’s a recap of our updates since our last newsletter in June.

IPE visit for FATs

In July, Project Manager Chris Lingham returned to IPE’s factory in Vietnam for the Factory Acceptance Test (FAT) of Menawethan’s electrical distribution boards. Joined by Piriou’s electrical quality control manager and a Lloyd’s Register surveyor, the visit confirmed the equipment meets all specifications and is ready for shipyard integration.

Megablocks 3 & 5

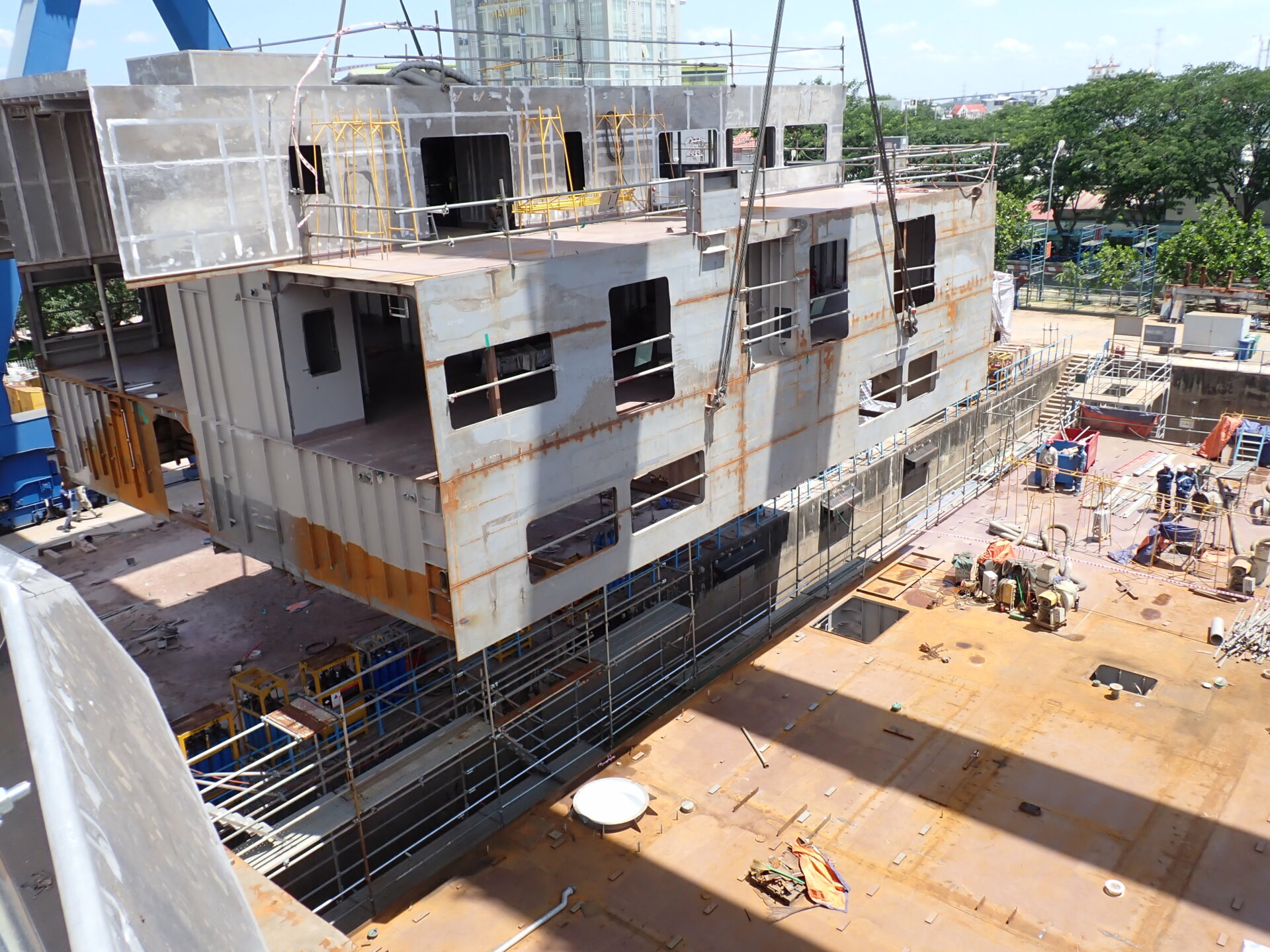

Megablock 3 has now been re-erected onto the hull, marking another key milestone in the vessel’s construction. Megablock 5 has also been positioned with ongoing work to bring all sections seamlessly together. See the videos in the section below for more information.

Scillonian’s main engines

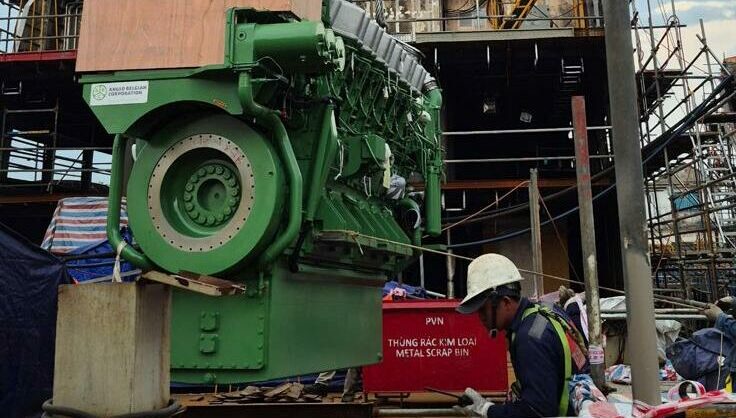

Both of Scillonian’s main engines were lifted into place in July – a major milestone in bringing her engine room to life. This precision operation marks the start of the next phase, with alignment and mounting to follow together with the installation of the propulsion control system.

France visit

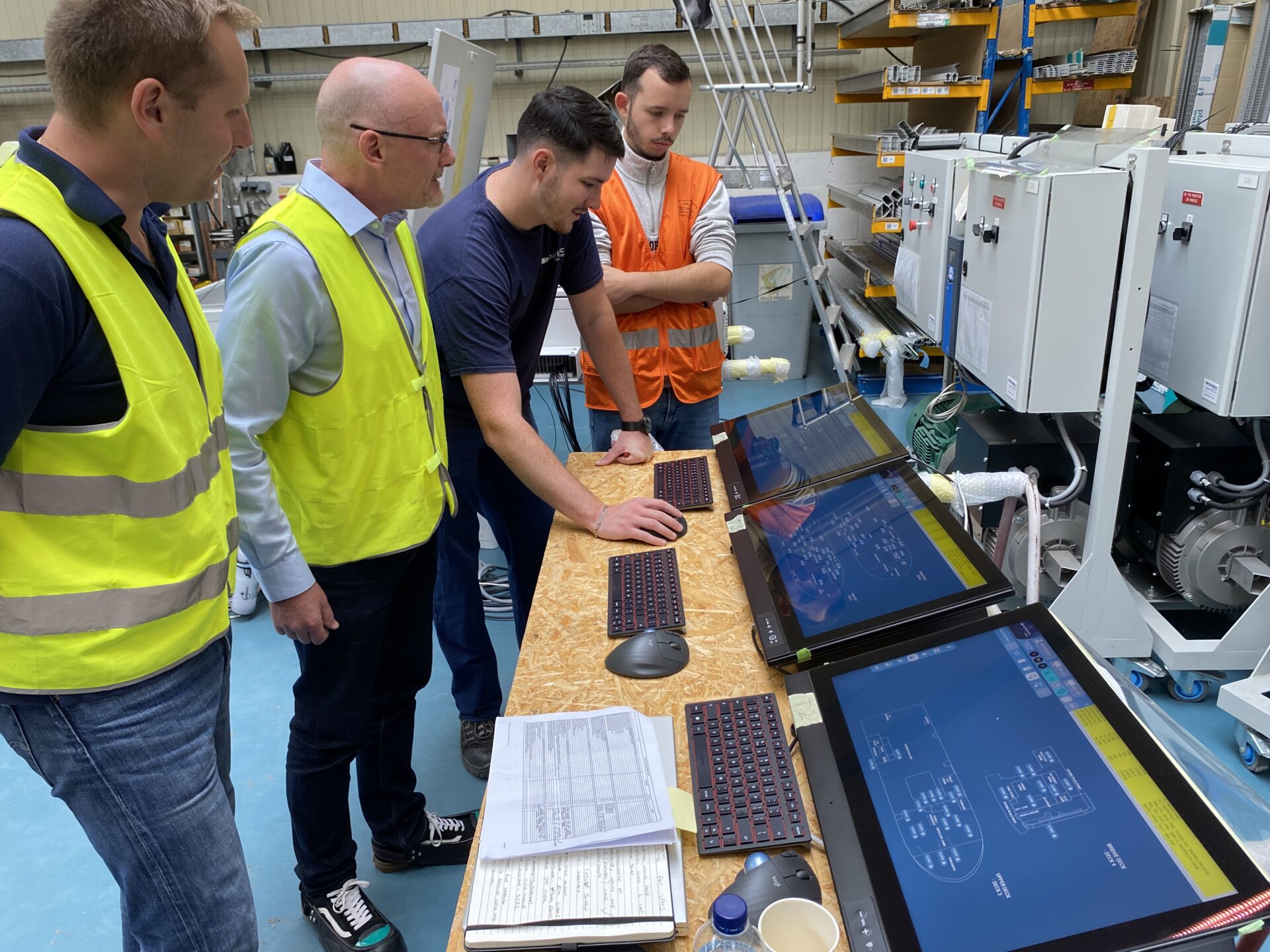

The Factory Acceptance Test (FAT) for Menawethan’s Integrated Platform Management System (IPMS) was successfully completed in France, attended by project manager Chris Lingham, a Lloyd’s Register surveyor, and Piriou’s technical manager. While there, Chris also joined design meetings for the automation, control, and monitoring systems for both vessels.

Video updates

Megablocks 3 & 5

Construction of both new vessels is progressing using a unit construction method, where smaller blocks are integrated into larger megablocks before being assembled onto the hull. The video updates below showcase the erection of megablocks 03 and 05 onto the Scillonian IV hull, highlighting the specific sections of the vessel they form.

Podcast – coming soon

A Q&A with Arjen Barendse, Sales Manager at Hull Vane.

In this episode, our Group Marketing and Communications Manager, Sharon Sandercock, sits down with Arjen Barendse from Hull Vane, to discuss the Hull Vane technology being installed on Scillonian IV, and what service improvements this will have for both our passengers and operations.

Menawethan Walkthrough

As the Menawethan build progresses, project manager Chris Lingham walks us through the various areas of the vessel showing how the vessel is taking shape over in Vietnam.


Workforce Spotlight

We are continually impressed with the highly skilled and dedicated workforce of around 285 people, including 70 painters (20 on night shift) working together to build our new vessels. The team is at the heart of the Scillonian IV and Menawethan builds – from steel hull construction to electrical cabling and interior outfitting, their professionalism and precision are driving rapid progress. Staff work in challenging conditions, including high heat, humidity, noise and dust, necessitating the use of full PPE as they work on and around the vessels, be it on scaffolding or crawling through tanks, all while maintaining strict health and safety standards.

Chief Executive Stuart Reid, who visited in August, praised the workforce’s skill and commitment. “The volume and quality of work completed in just 14 months is exceptional,” he said. Project managers Chris Lingham and Peter Broad, living in Vietnam, coordinate daily with the team, ensuring smooth progress and close attention to detail. Their leadership, combined with the workforce’s dedication, is key to delivering vessels that will set a new standard for service to the Scilly community.


Scillonian IV | Build Update

Hull and Structural Work

Steel and aluminium construction of Scillonian IV is nearly complete, with all vessel units now fully integrated in the building dock, with the exception of bow megablock 06, which is complete on the dockside and awaiting integration.  This will happen once Menawethan is launched. Installation of tunnel thrusters in the bow megablock is complete and work is underway to prepare for installation of the stern tubes in the stern of the vessel.

All of the passenger lounge windows are installed in decks 3 and 4 and work is underway in the elevator shaft with preparation to install the guide rails and elevator machinery.

The port fin stabiliser has been successfully integrated, while work continues welding up the starboard fin stabiliser.

Accommodation and Interiors

All crew accommodation, passenger accommodation, technical compartments, and most tanks have been blasted and received their first coat of paint, with paintwork in the aft cargo holds and on the bow megablock scheduled to begin shortly.

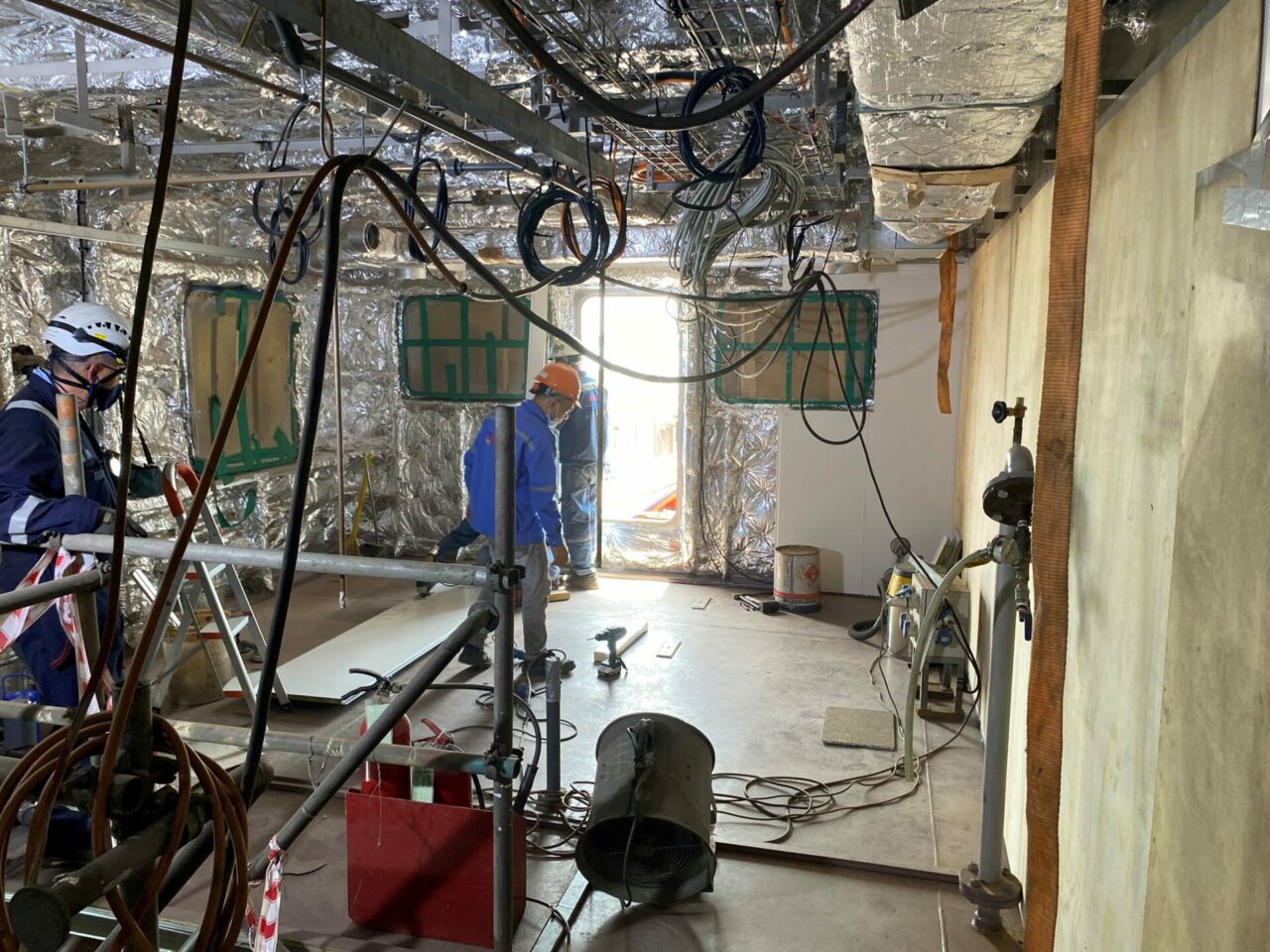

Windows for the crew areas and wheelhouse are fully installed, with just one left open in the wheelhouse for console and furniture access. Outfitting in crew accommodation areas and passenger lounges is progressing well, including installation of structure to support the bulkhead panels. Work with piping, ventilation ducts, electric cabling, and installation of thermal/fire boundaries is progressing well. Floating floors in the crew accommodation on deck 2 are also being installed.

Machinery and Technical Spaces

Work continues with installation of pumps, valves, compressors, fans, exhaust gas treatment plant, HVAC plant, refrigeration, sewage plants, electrical cabinets and the routing of piping and cabling to these . Acoustic dampening panels have been fitted in the auxiliary machinery room and crew accommodation to minimise noise transmission.

All main switchboards and transformers have been installed in the Engine Control Room, along with the main engine control console, with electrical cabling work ongoing. The main mast has been erected, which together with the monkey island (wheelhouse roof) has been blasted and painted.

Notable Progress

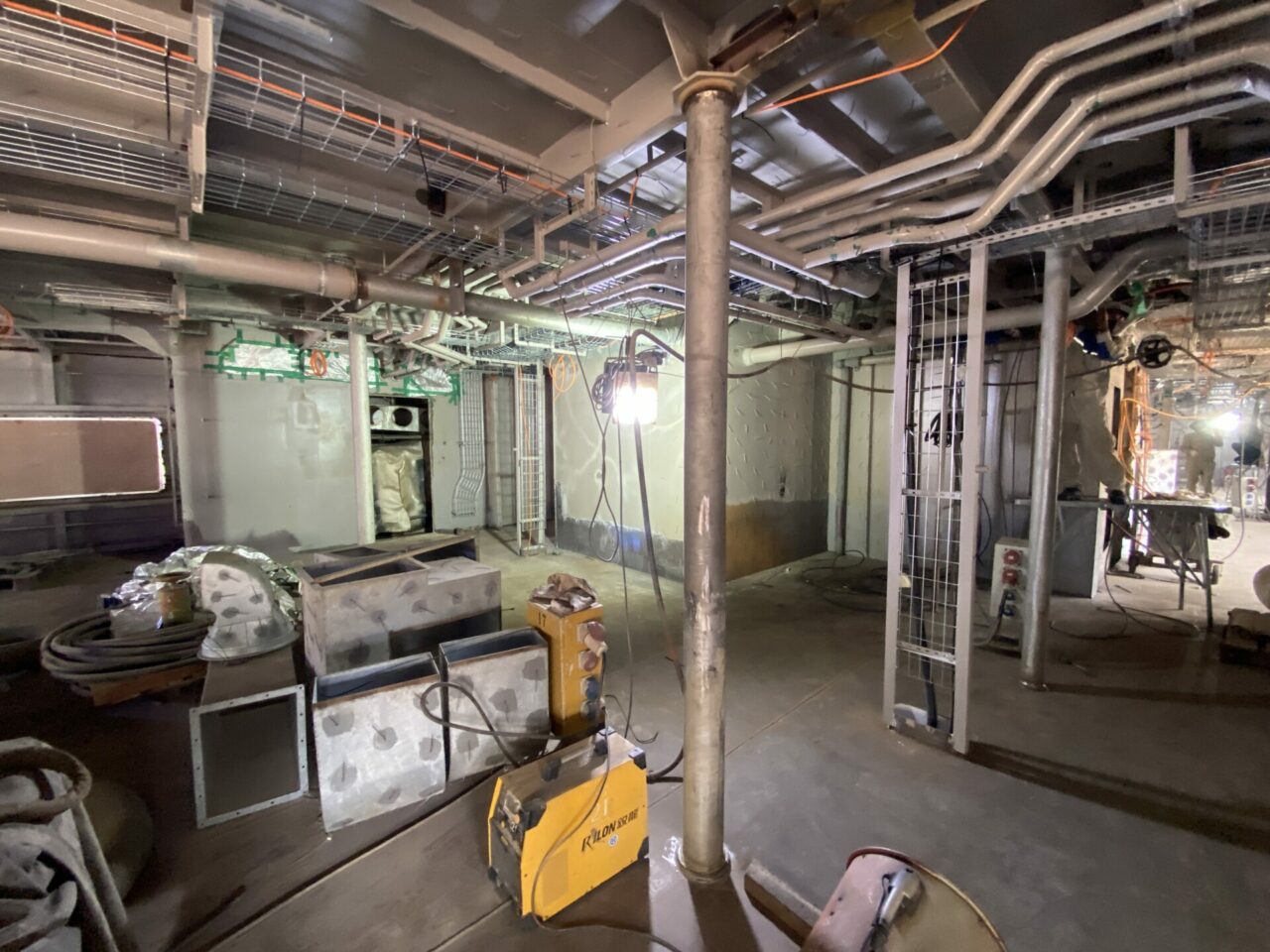

Passenger lounge windows were air-freighted and arrived at the yard earlier this month and all of the windows in the lounges on deck 3 and 4 have already been fitted. Outfitting work in crew accommodation and passenger lounges continues apace, with the installation of structure to support the bulkhead bulkhead panels, installation of ventilation ducting and a lot of electrical cabling being run. The wheelhouse outfitting is ongoing, with good progress seen with the outfitting of the Master and Chief Engineer’s cabins on deck 5.

Overall, the level of progress on both structural and interior work in just 14 months has been impressive.

Next Steps

Over the coming months, Chris and Peter will continue to lead detailed design reviews and monitor progress closely with the shipyard. They will also review outstanding action items and cost options with Piriou, ensuring that every element meets our high standards. Preparations are underway for the vessels to enter service, including crewing, certification, and familiarisation, while continued inspections will ensure all work is completed to specification.


Menawethan | Build Update

Hull and Structural Work

Steel construction of Menawethan is complete, with all vessel sections fully integrated together including the main mast. Blasting and first coat painting is complete across all internal and external areas, including the hull, bulwark, top deck, hatch coamings,  cargo holds and tanks. Installation of inner stern tubes is complete, with tailshafts and propellers installed, and rudder stocks and rudders mounted. Work is now progressing with the installation of the Wills-Ridley steering gear.

Machinery and Technical Spaces

Significant progress continues in the machinery spaces, with the installation of pumps, valves, compressors, fans, and the exhaust gas treatment plant. Several pipe systems have now been completed and pressure tested, including fuel transfer, fuel cargo, bilge, lube oil, ballast, and fire main systems. Installation of HVAC, refrigeration, and sewage plant continues, alongside other mechanical and technical outfitting.

Accommodation and Interiors

Outfitting of crew accommodation and passenger lounges is progressing well. Thermal, fire boundary, and acoustic insulation for bulkheads and deckheads in accommodation and technical spaces is approaching completion, ensuring compliance with statutory regulations and providing a comfortable environment for our crew and passengers. The installation of bulkhead panels in the crew and passenger accommodation is around 75% complete. En-suite units have been installed for the crew cabins, with plumbing and vacuum piping installation progressing steadily, ensuring that all accommodation spaces are moving toward completion.

Electrical and Systems Installation

Many of the electrical distribution boards and starter cabinets have now been installed and a lot of work has been done to install electric cabling throughout the vessel.

Next Steps

Continued outfitting work to fully mount machinery and route piping and electric cabling. Complete painting of internal areas and tanks. The underwater and topsides of the hull have already received the first coat of paint, the next step being to apply further coats of paint, totalling 4 coats for the topsides and 5 coats for the underwater areas.

Continued outfitting work in the accommodation areas to install ceiling panels, ventilation outlets and flooring. And in the wheelhouse next step is to install the consoles that house the manoeuvring, navigation and control systems for the vessel.

Our teams continue to monitor progress closely to ensure all work meets high standards, as the build of the vessel moves closer to launching and the start of commissioning.
